For construction financial managers, navigating progress billing is often a tedious cycle of delayed payments and administrative bottlenecks. This friction typically stems from a deeper challenge in project administration: translating complex, physical job site milestones into clear, auditable financial documentation that owners and lenders can easily verify.
Aligning your billing process with the correct Schedule of Values (SOV) format unlocks faster payment approvals and drastically reduces contract disputes. However, achieving this efficiency requires a clear caveat: your billing sheet must align precisely with the specific breakdown requested by the project architect or owner, as there is no one-size-fits-all template.
Utilizing industry-standard formats, such as the AIA G702 and G703 style sheets, provides the structural transparency needed to prove completed work. In this article, we will examine how to select the right SOV layouts, categorize work phases accurately, and implement a streamlined billing workflow that accelerates cash flow.

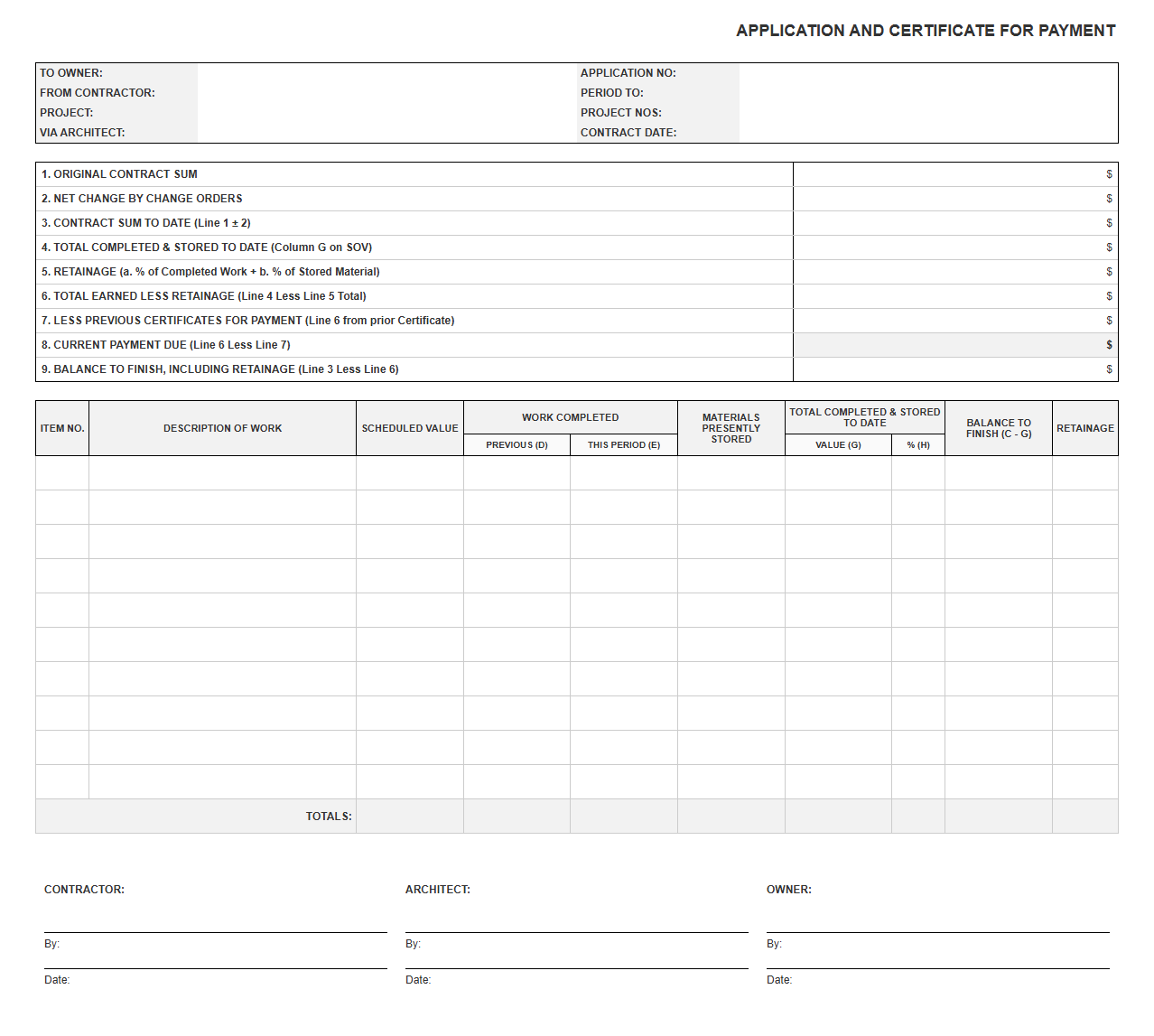

Construction Schedule of Values Invoice Template
Download: .PDF

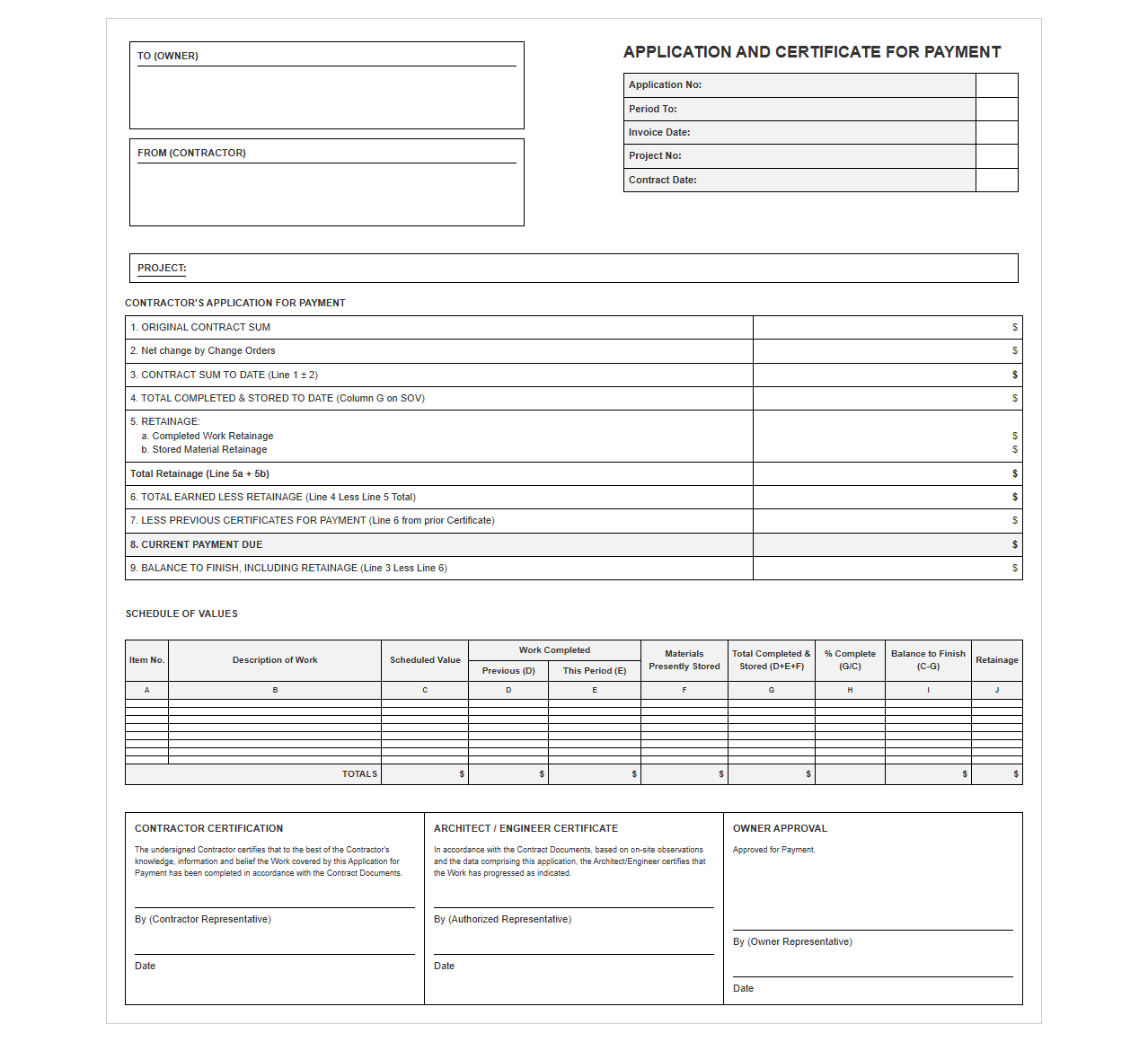

Progress Billing Invoice with Schedule of Values
Download: .PDF

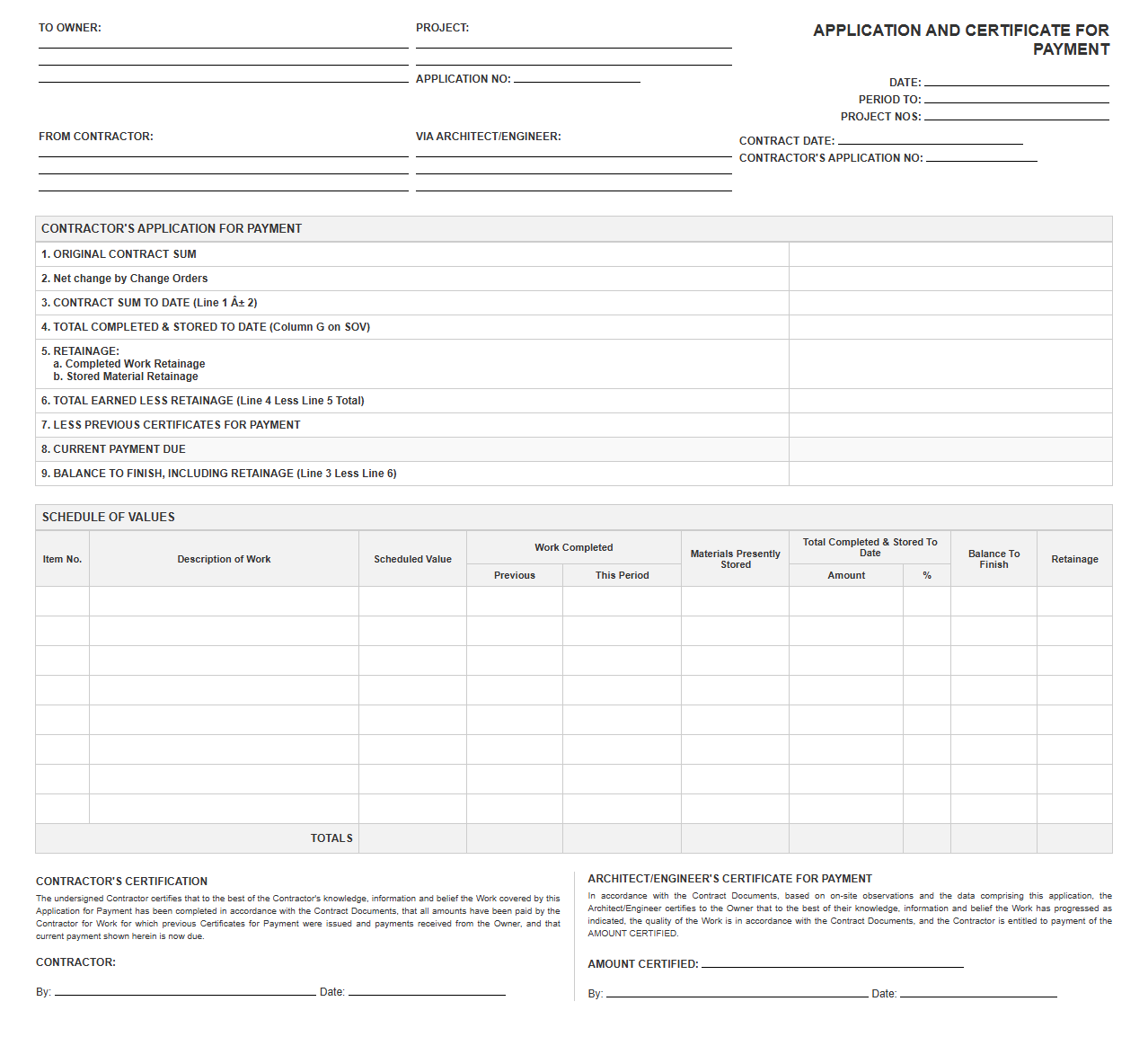

SOV Progress Billing Invoice Template
Download: .PDF

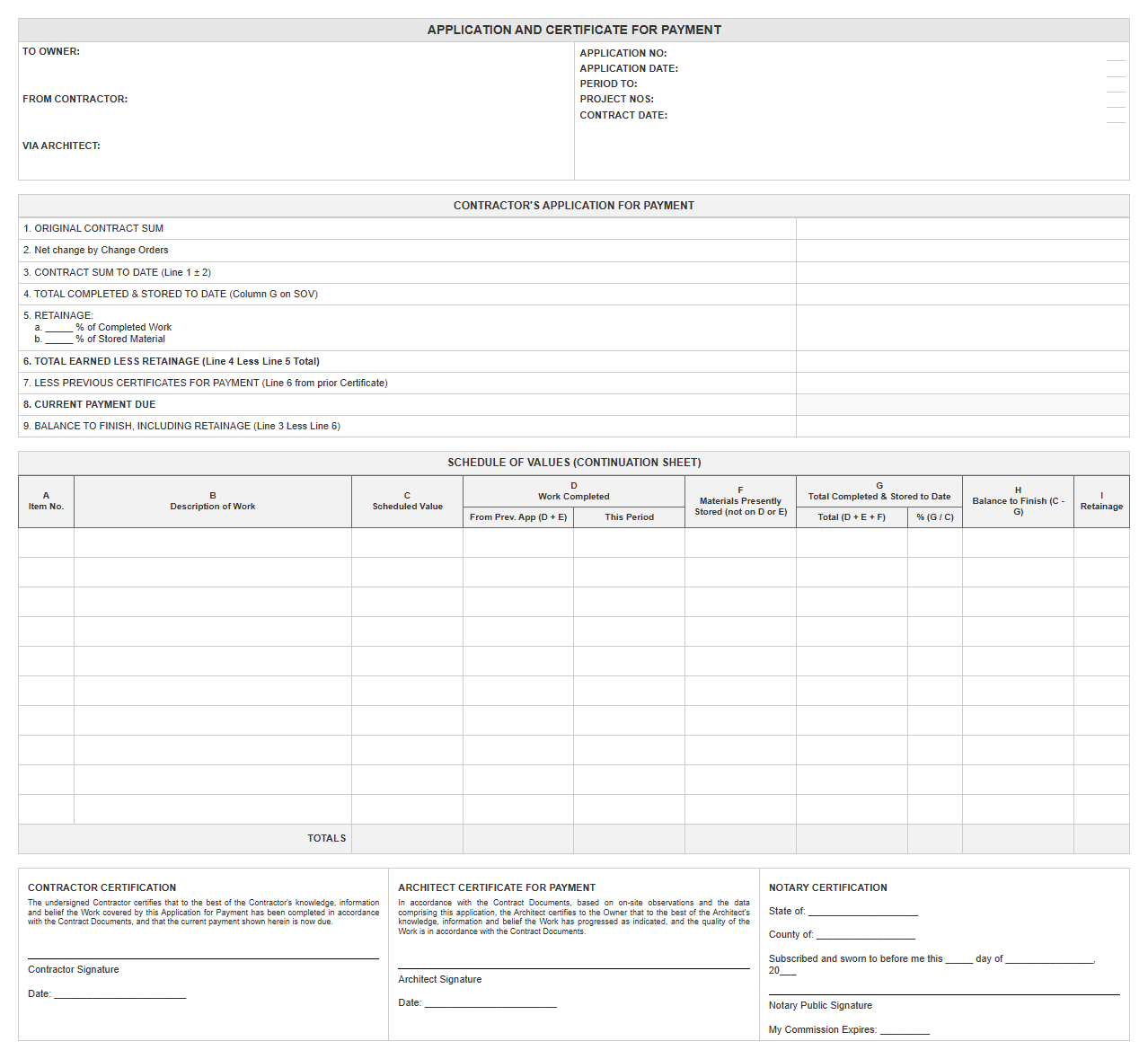

AIA Style Schedule of Values Billing Template
Download: .PDF

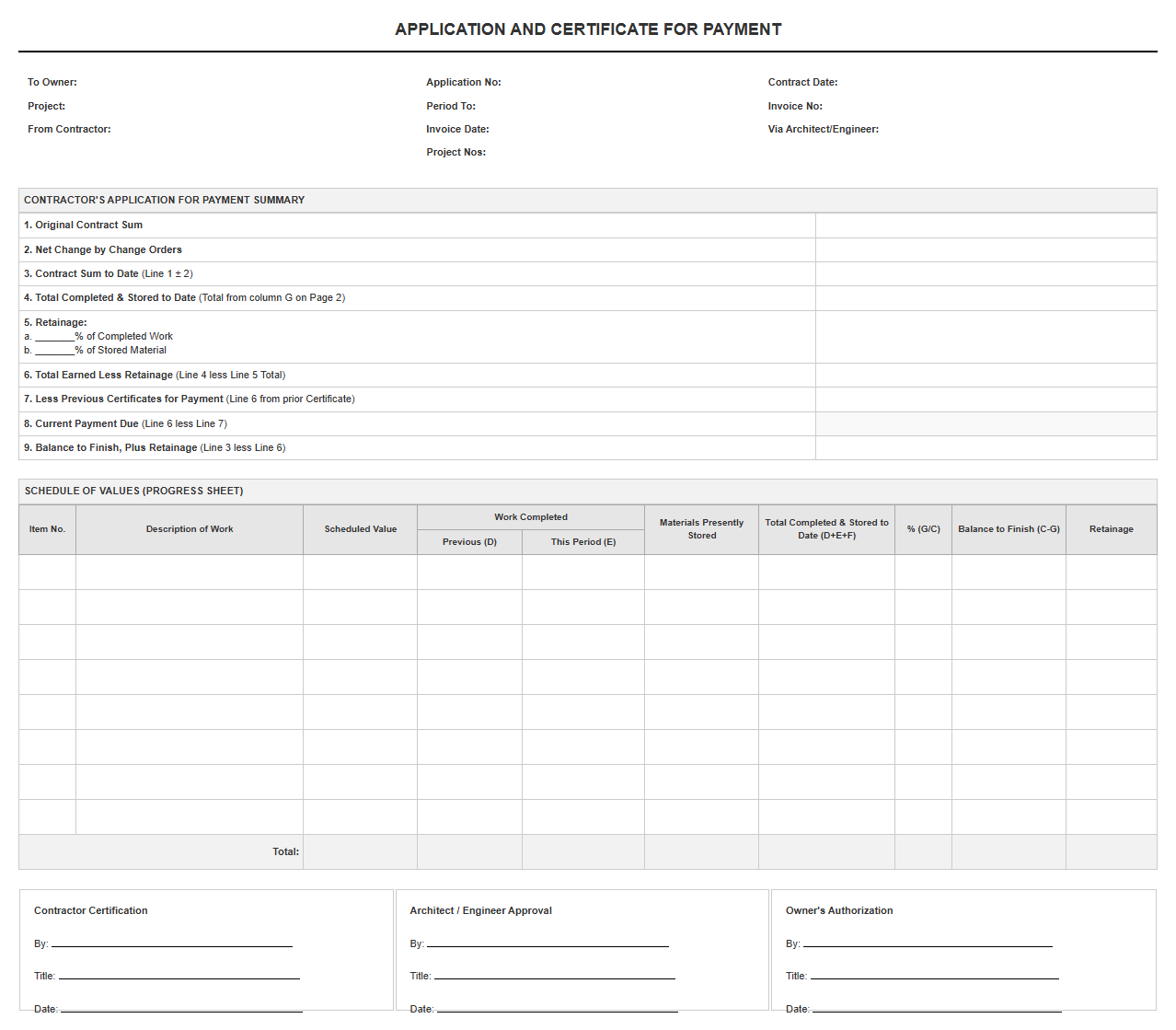

Contractor Schedule of Values Progress Invoice
Download: .PDF

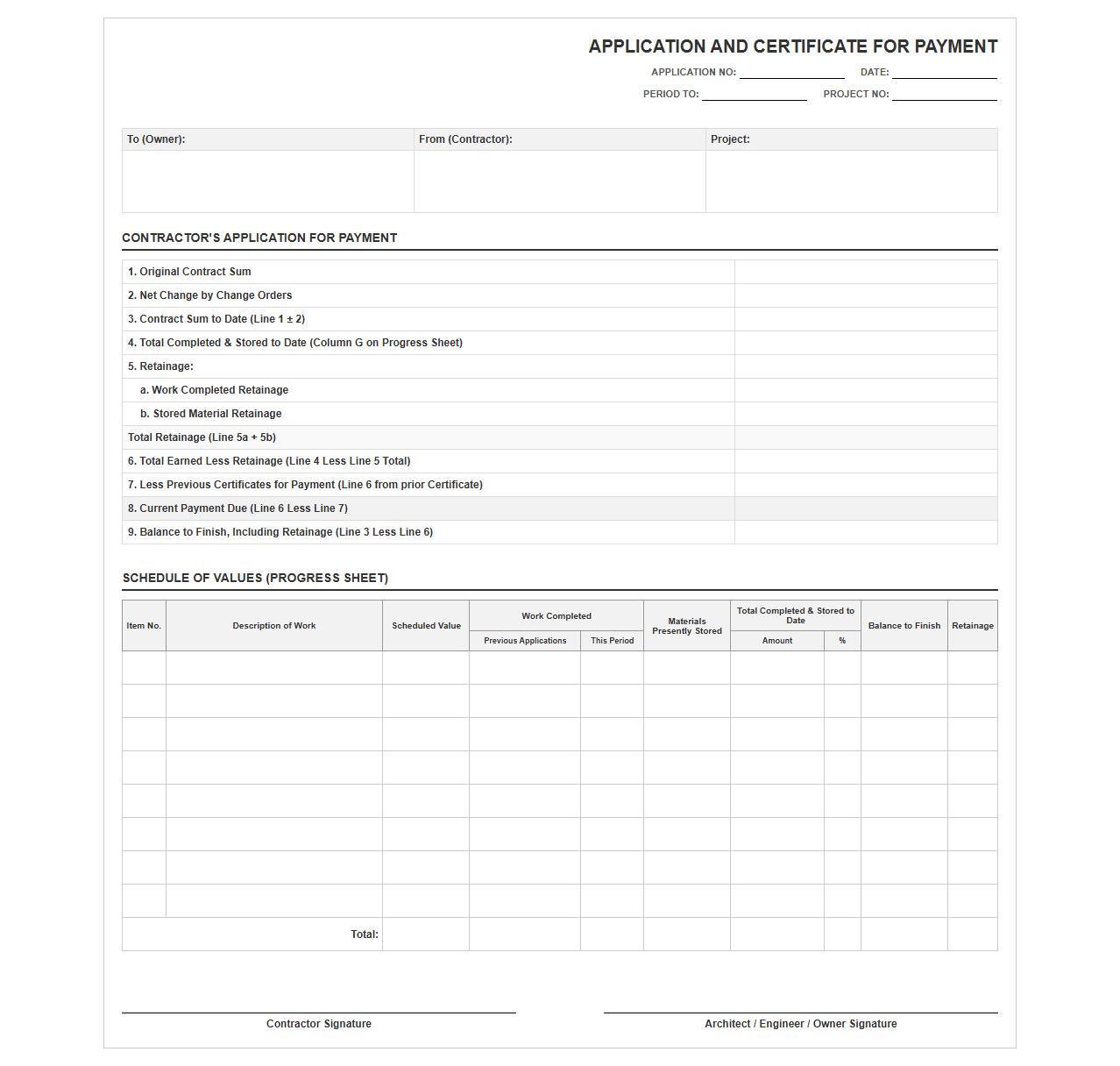

Percent Complete Schedule of Values Invoice
Download: .PDF

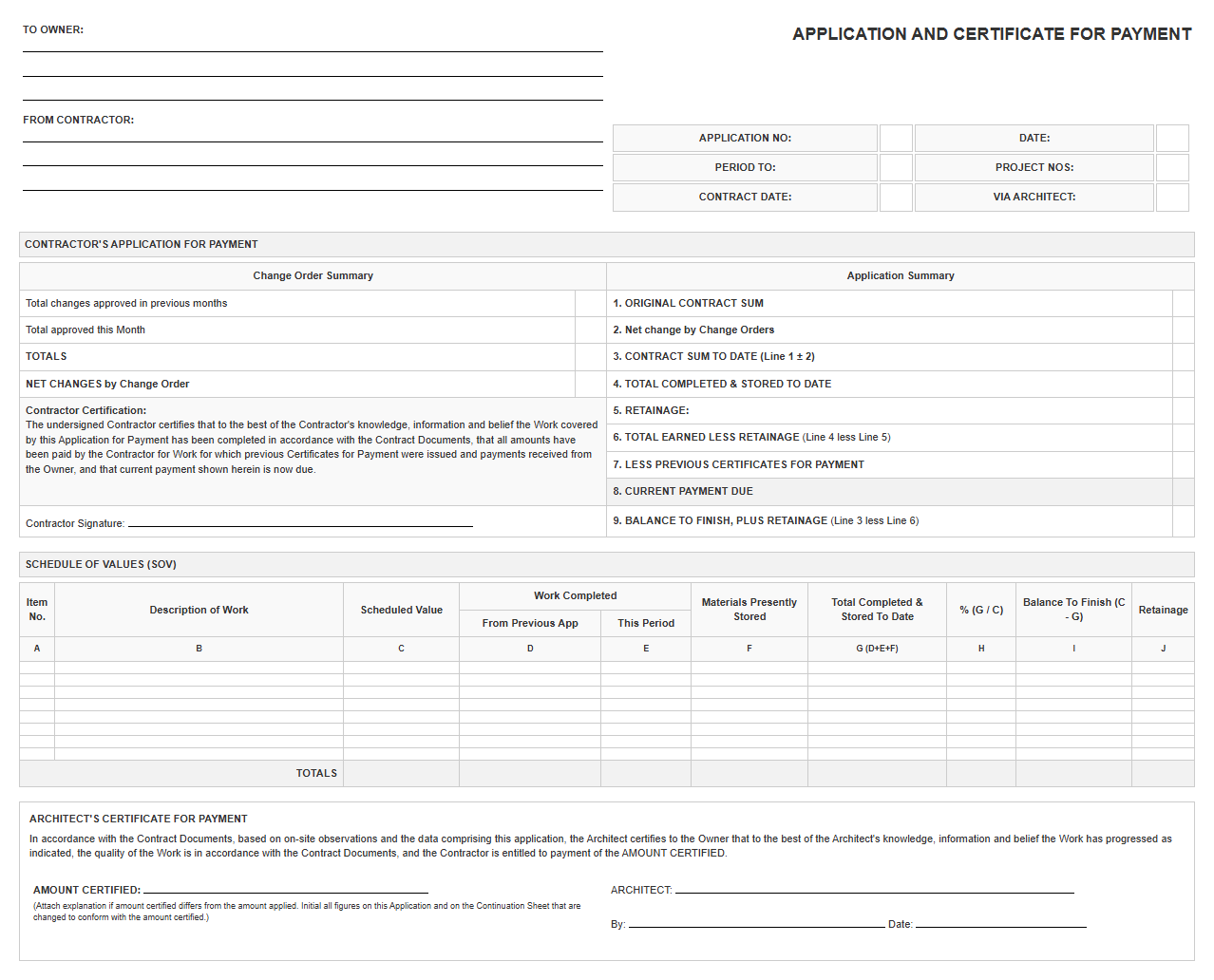

Commercial Construction SOV Billing Template
Download: .PDF

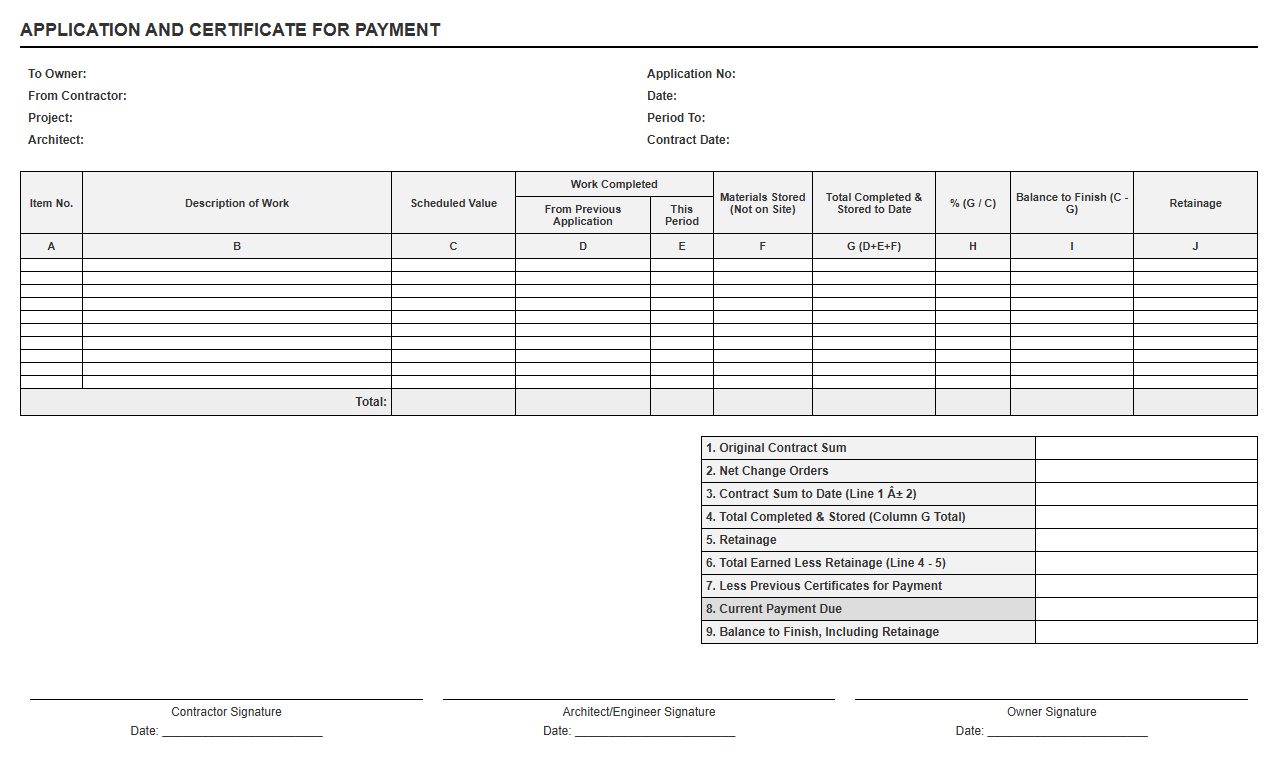

Schedule of Values Progress Draw Template
Download: .PDF

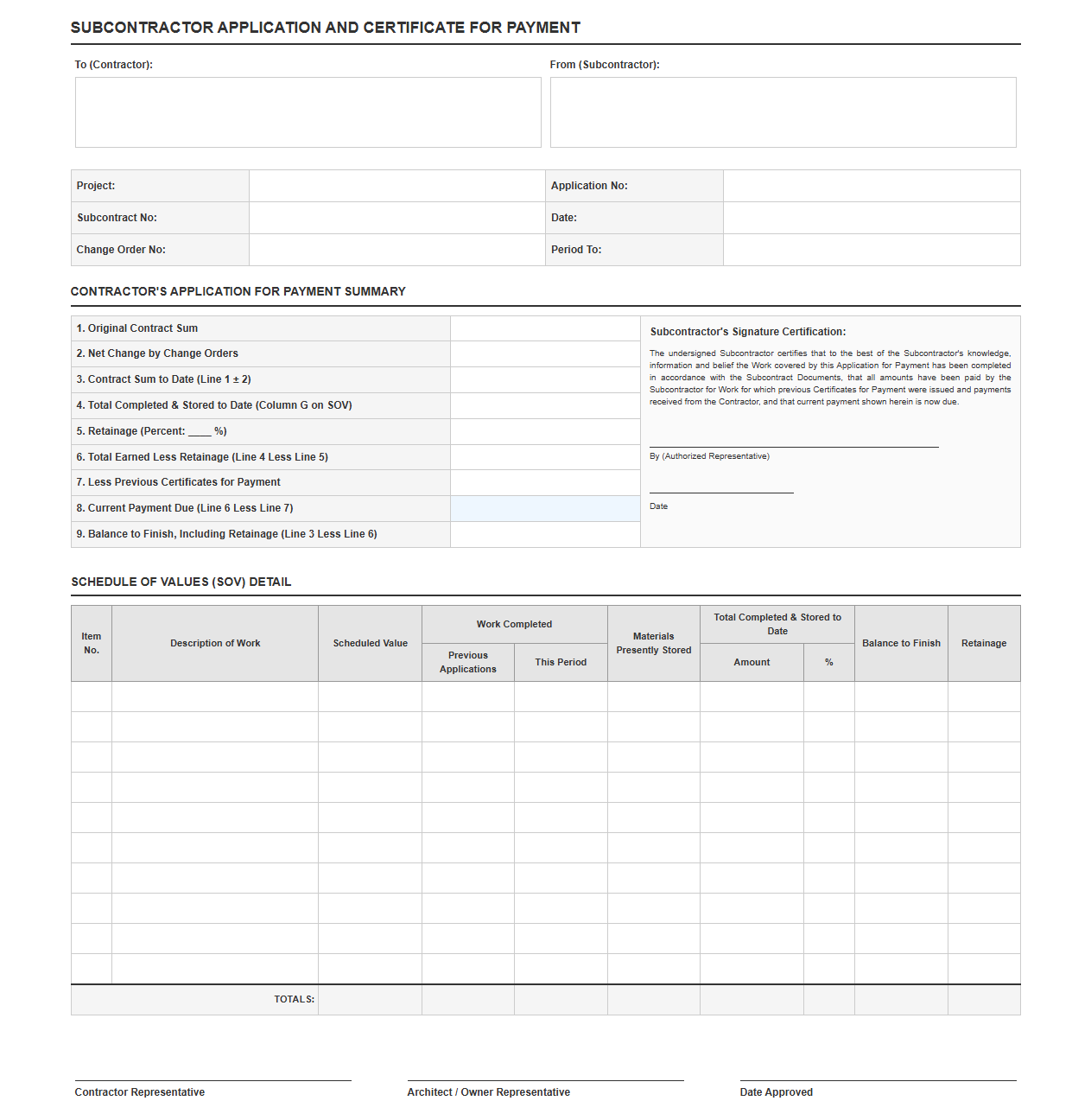

Subcontractor Schedule of Values Billing Invoice
Download: .PDF
Demystifying Progress Billing and the Schedule of Values
In the construction industry, managing cash flow is the heartbeat of a successful project. Unlike traditional retail transactions where payment is exchanged immediately upon delivery, construction projects require a specialized financial framework known as progress billing. This method allows contractors to bill progressively throughout the life of a project based on the percentage of work completed.
At the center of this process lies the Schedule of Values (SOV). The SOV acts as a comprehensive, itemized budget that represents the entire contract sum allocated to specific work items. When progress billing and the Schedule of Values work in tandem, they create a transparent, predictable roadmap. This synergy ensures that developers, architects, and contractors stay aligned, reducing financial friction and maintaining the steady flow of capital necessary to keep the job site active and productive. Mastering this relationship is essential for preventing project delays and securing steady cash flow.
Structural Pillars of an Effective Schedule of Values
A well-structured Schedule of Values is the foundation of hassle-free payment cycles. It translates the broad contract price into manageable, verifiable increments of work. To satisfy project owners, lenders, and architects, every standard SOV must include several core components:
- Item Number and Phase Codes: Unique identifiers that organize the project sequentially by division or work phase.
- Description of Work: Clear, unambiguous descriptions of the specific tasks, materials, or divisions being tracked.
- Scheduled Value: The total dollar amount allocated for each specific line item, representing the complete cost of labor, materials, overhead, and profit.
- Work Completed in Previous Periods: The cumulative financial value of work approved and completed prior to the current billing cycle.
- Work Completed in the Current Period: The exact monetary value of labor performed and materials installed during the active billing timeframe.
- Materials Presently Stored: The value of materials purchased and stored securely on-site or in an approved off-site warehouse, but not yet installed.
- Total Completed and Stored to Date: The sum of all work completed and materials stored since the project's inception.
- Percentage of Completion: A calculated ratio showing how much of the scheduled value has been fulfilled for each line item.
- Balance to Finish: The remaining dollar amount required to complete each portion of the work.
- Retainage: The percentage of funds withheld by the owner until the project reaches substantial completion, protecting against outstanding punch list items.
Choosing the Right Invoice Format: Standard vs. Customized
Contractors often must choose between using traditional, widely recognized industry-standard forms or designing customized digital templates tailored to specific project needs. Understanding the differences between these formats helps determine the best fit for your project structure.
| Billing Format | Key Characteristics | Primary Advantages | Ideal Use Cases |
|---|---|---|---|
| Standard AIA G702/G703 | Industry-standard forms featuring a summary application (G702) and a detailed continuation sheet (G703). | Universally recognized by architects, banks, and lenders; minimizes legal disputes and standardizes review. | Large commercial projects, public works, and projects with institutional financing. |
| Customized Digital Templates | Bespoke invoices generated by modern construction accounting software, tailored to specific workflows. | Highly flexible, integrates with live project data, and allows for automated math calculations and branding. | Residential projects, specialty subcontracting, and agile projects with rapid turnaround times. |
Transitioning from Manual Spreadsheets to Digital Workflows
For decades, contractors relied on manual spreadsheets to calculate percentages, compile invoices, and track stored materials. However, manual entry presents severe limitations, including formula errors, broken links, version control issues, and delays in communication. A single mistyped decimal point can derail a payment application, leading to weeks of review and stalled cash flow.
"Transitioning to automated, digital Schedule of Values tracking replaces human error with real-time financial accuracy. By centralizing billing data, contractors can generate error-free progress applications instantly, allowing project managers to focus on building rather than troubleshooting spreadsheets."
Step-by-Step Guide to Submitting a Progress Billing Invoice
- Review the Contract and SOV: Ensure the initial Schedule of Values is approved by the owner or architect before the first billing cycle begins.
- Assess On-Site Progress: Walk the job site to verify the physical completion percentages of each line item for the current period.
- Document Stored Materials: Compile invoices, photos, and insurance certificates for materials stored on-site or in off-site warehouses that you intend to bill for.
- Calculate Progress and Retainage: Update the continuation sheet with current progress figures and apply the designated retainage rate.
- Draft the Pay Application: Compile the data into the chosen format, ensuring all mathematical calculations are double-checked and accurate.
- Submit for Architect/Owner Review: Send the completed application along with necessary lien waivers and supporting documentation.
- Revise and Finalize: Address any questions or adjust line items based on feedback from the reviewing party to secure final approval.
Overcoming Common Errors in Schedule of Values Management
Many progress billing disputes stem from preventable mistakes during the preparation phase. One frequent pitfall is front-loading the schedule. This occurs when a contractor artificially inflates the value of tasks scheduled early in the project, such as mobilization or site preparation, to secure early cash. While it aids short-term cash flow, it leaves the project underfunded in the later stages, causing owners and lenders to lose confidence and reject payment applications.
Another prevalent issue involves mathematical discrepancies between the continuation sheets and the master application. Minor rounding errors can trigger automatic rejections by modern accounting platforms or eagle-eyed architects. Additionally, failing to account for approved change orders directly on the SOV leads to confusion. Rather than blending change orders into existing line items, they should be listed as separate, distinct entries to preserve transparency and ensure smooth billing approvals.
Best Practices for Faster Approvals and Consistent Cash Flow
To establish a frictionless billing cycle, proactive communication is key. Organizing a pre-billing meeting with the architect and owner before the official submission date allows all parties to agree on completion percentages. This pencil-copy review prevents unexpected rejections and speeds up the formal approval process.
Furthermore, supporting every progress claim with robust documentation builds lasting trust. Providing clear photographic evidence of completed work, organized material receipts, and signed lien waivers shows owners and lenders that your financial management is as precise as your craftsmanship. Implementing these structured practices turns progress billing from a monthly headache into a competitive business advantage.
